Construction Schedule By Lot/Unit Report



Please Note: The report has been shrunk down and converted to an image for those viewing with small screens.

The actual reports are much more clear.

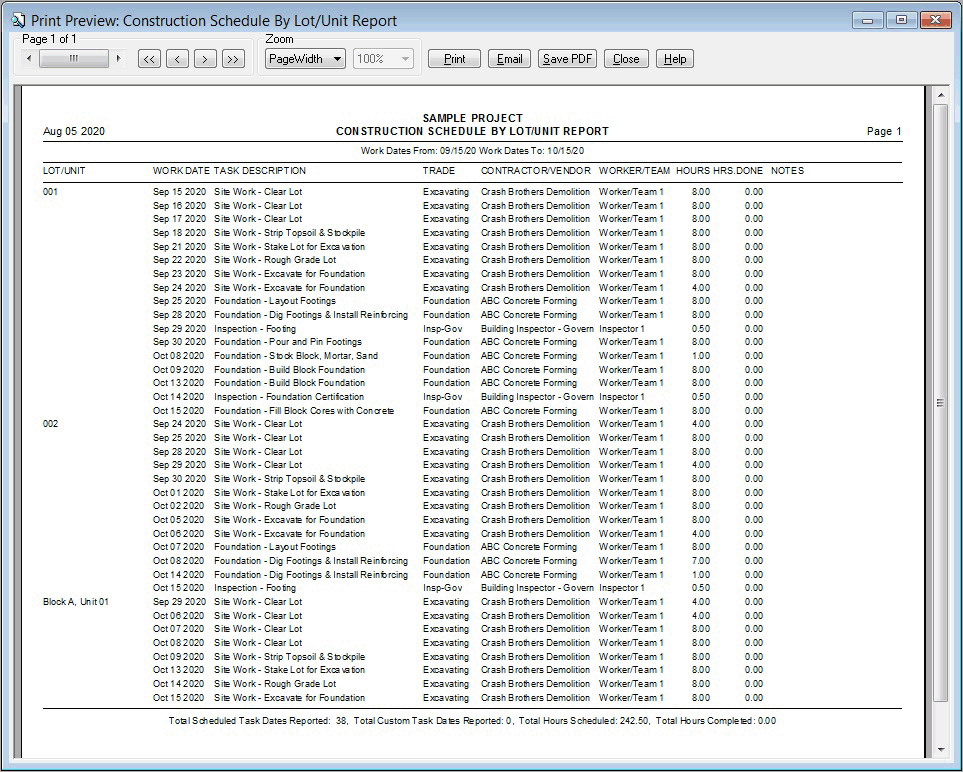

The Construction Schedule by Lot/Unit Report is a great tool to list scheduled tasks and can be filtered by Lot/Unit, Trade category,  Contractor, Worker/Team, Dates, specific tasks or groups of tasks etc in any combination. This example lists tasks for a 1 month time period, and is sorted by Lot/Unit, but it may also be sorted by date.

This report is ideal for providing up-to-date lists of scheduled tasks, and may filtered for and emailed directly to specific contractor(s).
